Call (907) 416-5802
Standing-seam metal roof under winter snow in Anchorage
Engineered snow management

Snow Retention in Anchorage — Engineered to Your Roof's Snow Load

When a winter's worth of snow lets go of a metal roof, it comes down all at once — onto decks, entryways, gas meters, vehicles, and anyone standing below. Snow retention holds that load on the roof and releases it as meltwater instead. We engineer every layout to your roof's actual snow load, install it with the attachment your roof type requires, and document the whole system in your job file.

★★★★★ rated by Anchorage homeowners and HOAs on Google

Safety first

This is a safety product. Anchorage's own guidance says so.

Roof avalanches aren't a theoretical risk here. The Municipality of Anchorage's building-safety guidance states plainly that falling roof snow and ice has caused fatalities in Anchorage, that a metal roof "can avalanche the entire snow load in an instant, without warning" — and it recommends exactly two responses for the area below a sloped metal roof: install snow guards, or block off the area all winter.

There's a structural side too. The same guidance flags buildings built before 1990 — before Anchorage's code required roofs to be designed for drifting snow — as the ones that fail. Most local roof failures involve wood trusses from that era, often at loads below today's code minimum, and the Municipality advises removing heavy drifts from those roofs all winter unless a structural engineer has cleared the structure. That's why our assessment starts with the building, not the product: holding snow on a roof only makes sense if the roof can carry it, so on older buildings we check the structure first — and bring in an engineer when it's in doubt.

We'd rather your walkway stayed open. A properly engineered retention system holds the snowpack in place so it leaves your roof the safe way: as water, through your drainage path — not as a quarter-ton slab.

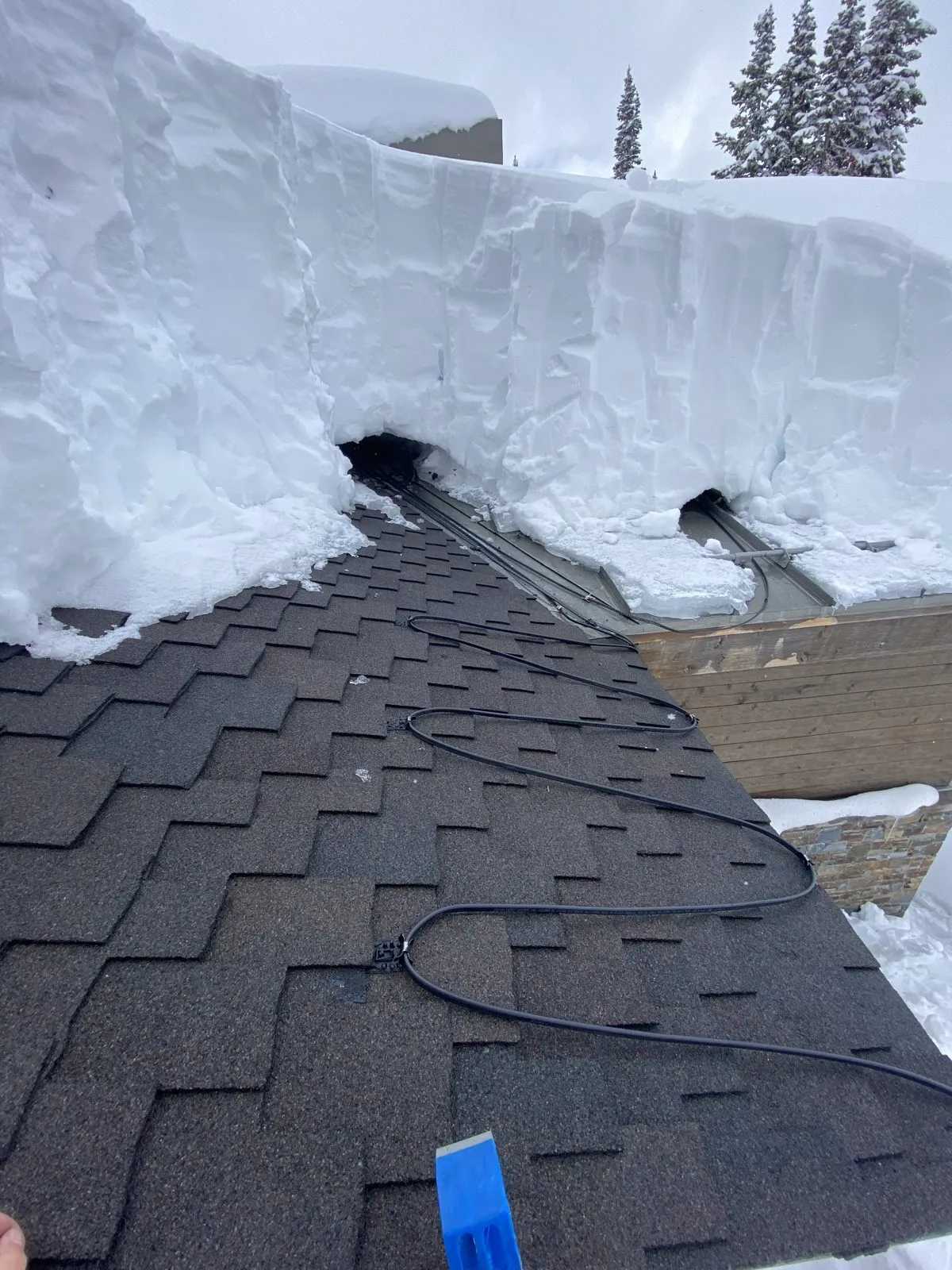

A heavy snow slab creeping over a roof edge in Anchorage A winter's snowpack leaves a roof one of two ways — engineered, or all at once
The math, not the eyeball

Engineered, not eyeballed

Snow retention only works when there's enough of it, in the right places. The load it has to hold is a calculation — your roof's snow load, pitch, and the length of roof feeding each row — not a guess. Anchorage roofs are designed around a 50-pounds-per-square-foot ground snow load, and it climbs from there: higher elevations on the Hillside add load with every hundred feet, and Girdwood carries nearly three times the Anchorage base.

So we don't eyeball it. For every job, we run your roof's measurements through the manufacturer's engineering — and the layout that comes back determines how many rows you need and exactly where they go. That layout goes in your job file, and you get a copy. It's the difference between a system designed to hold your roof's snow and a row of parts that looks like one.

One thing we won't do: install a single "courtesy row" at the eave. An under-built system implies protection it can't deliver — when the pack releases, it goes over or through it. If a roof needs four rows, the honest quote says four rows.

Matched to the roof

The right system for your roof

Different roofs hold snow guards differently, and using the wrong attachment is how systems fail. We match the system to the roof:

01

Standing-seam metal

Clamp-mounted rail systems that grip the seams without a single hole in the panel. The clamps pinch the seam; they don't pierce it — your panels keep their finish and their warranty.

02

Corrugated & exposed-fastener metal

Face-mounted brackets, mechanically fastened through the panel into solid backing with gasketed roofing screws, sealed at every penetration.

03

Asphalt shingle

Bar and pad systems fastened through the shingle into the roof deck itself, with the mounting strap tucked under and waterproofed by the shingle course above. Never surface-attached, never shingle-only — the deck is what carries the load.

The honest answer

"Wait — don't you glue everything?"

Fair question. Our heat cable standard is zero penetrations: every cable clip is glued, because cable clips carry almost no load and your roof doesn't need holes for them.

Snow retention is the opposite problem. A retention row can be asked to hold thousands of pounds of snow — and every engineering authority in the roofing industry, plus the manufacturers' own load testing, says the same thing: structural loads need mechanical attachment. Glued-on snow guards hold a fraction of what a fastened system holds, and Anchorage's snow loads are beyond what adhesive systems are even rated for.

So the principle is the same one, applied honestly: the attachment matches the load. No-load cable clips get glue and zero holes. Load-bearing snow retention gets engineered mechanical attachment — fastened right, gasketed, and sealed, so it holds for the life of the roof without leaking.

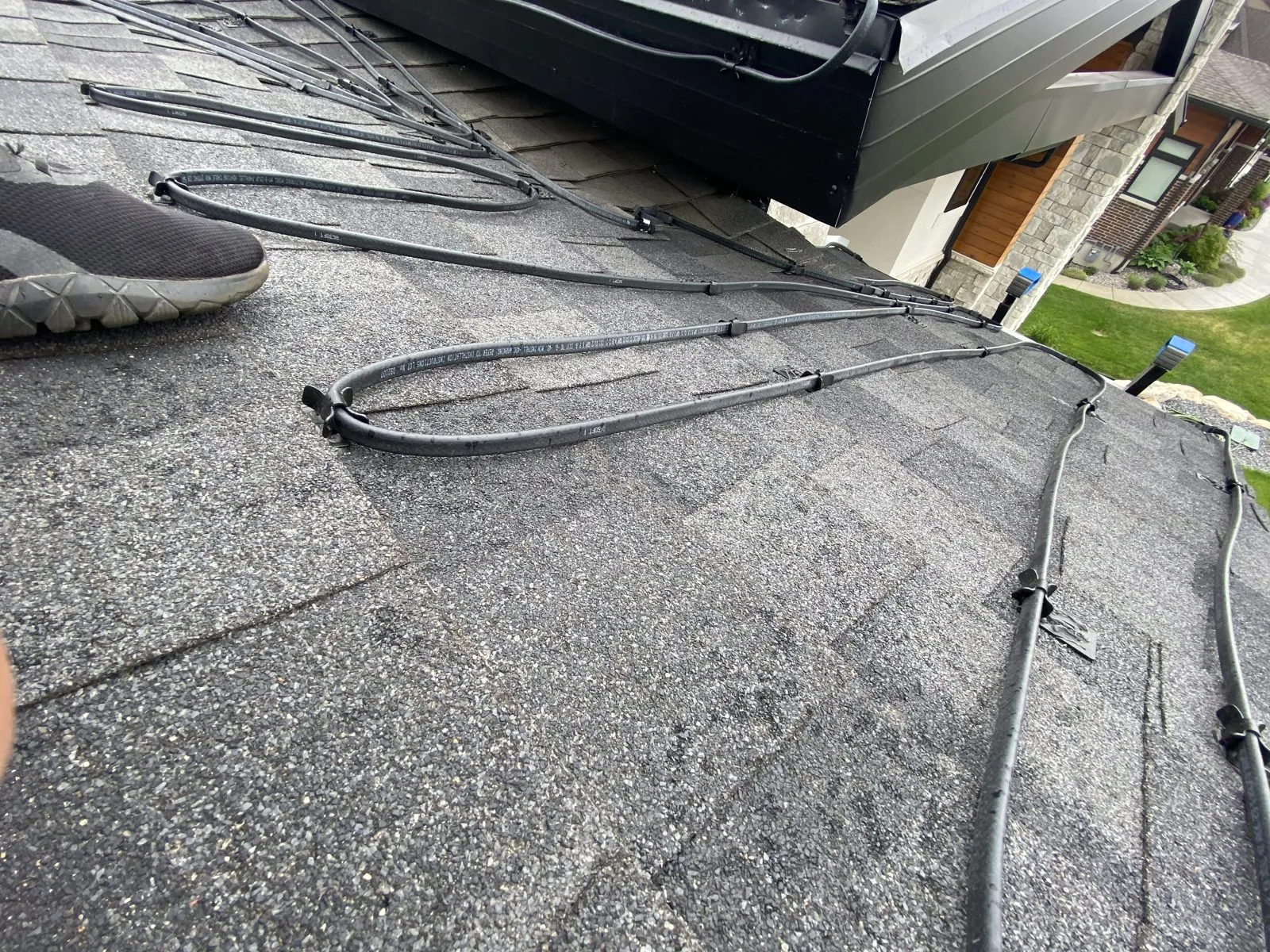

Glued heat cable clips — the zero-load, zero-penetration side of the principle No-load cable clips: glued. Load-bearing retention: engineered fasteners.
Better together

Snow retention + heat cable: one system, not two products

On a slick roof, these two protect each other:

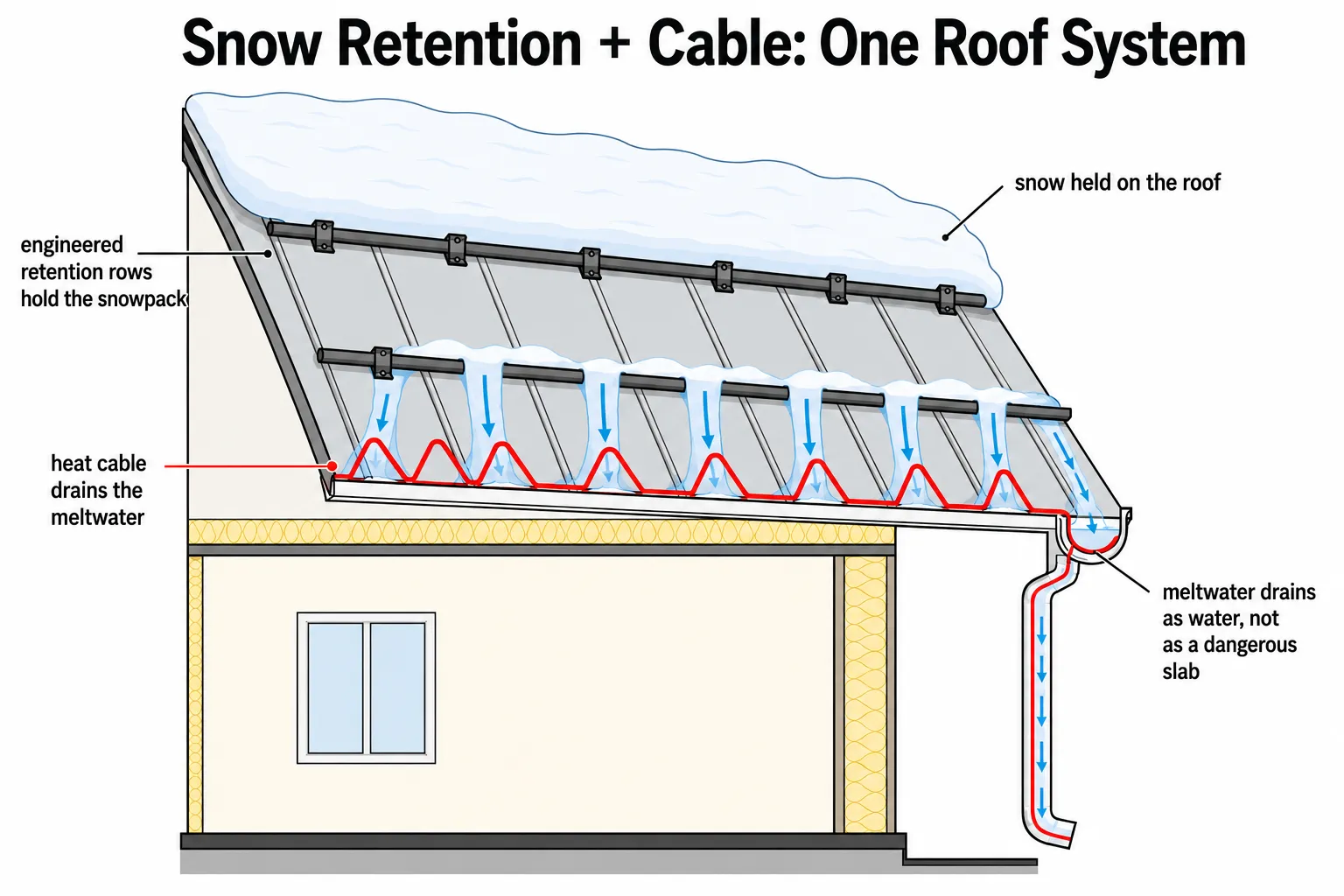

Cross-section of a roof showing snow retention and heat cable as one system: engineered retention rows hold the snowpack while heat cable drains the meltwater off the roof as water, not as a dangerous slab

Retention protects the cable.

A roof avalanche doesn't just threaten what's below — it can shear off heat cable and gutters on its way down. Retention rows above the eave hold the pack so your de-icing system survives the winter it was built for.

Cable drains what retention holds.

A retained snowpack still melts from underneath. Heat cable at the eaves, valleys, and downspouts gives that meltwater a path off the roof — without it, held snow can feed the very ice dams you're trying to prevent.

That's why we design them together: retention rows up-roof, cable managing the drainage path below. If you're getting heat cable on a metal roof, we'll tell you honestly whether it needs retention above it — and if you only need one of the two, we'll tell you that too.

What to expect

The process

STEP 01

Site assessment

Roof type, pitch, measurements, elevation, and what's below your eaves. We also check the things most installers skip: whether your roof was engineered to shed its snow (some metal buildings are — retention on those needs an engineer's sign-off first) and whether the structure is suited to holding a retained snowpack.

STEP 02

Engineered layout + quote

Your measurements go through the manufacturer's engineering; you get a quote built on the returned layout, with the row count and placement shown, not implied.

STEP 03

Installation

The right attachment for your roof type, every penetration gasketed and sealed, installed to the manufacturer's spec so their warranty stands behind it.

STEP 04

Documentation

Photos of the attachment points, the completed rows, and the finished field, stored with your layout in your job file.

Questions

Snow retention questions, answered straight

Do snow guards actually stop roof avalanches?

A properly engineered system holds the snowpack so it melts and drains instead of releasing as a slab. No snow retention system can promise 100% effectiveness — the industry's own engineering standard says exactly that, and you should be skeptical of anyone who claims otherwise. What engineering changes is the odds: a calculated layout holds the load it was designed for; a decorative row doesn't.

How much does snow retention cost in Anchorage?

It depends on the length of roof feeding each row, your roof type, and your snow load — which is why we run the engineering before we price. The quote shows the layout you're paying for. Retention is often bundled with a heat cable install, and it's significantly cheaper than the deck, gutter, or vehicle damage a single slide can cause.

Will the fasteners leak or void my roof warranty?

On standing seam, nothing is pierced at all — the clamps grip the seam. On shingle and corrugated roofs, every fastener lands in solid backing, gasketed or sealed, and installed to the manufacturer's published spec — which is what keeps their warranty behind the system. We photograph the attachment work so you have the record.

My roof already slid once. Can you add retention without redoing the roof?

Usually, yes — retrofit systems exist for shingle and metal roofs, and adding retention doesn't require a re-roof. If the slide took your heat cable or gutters with it, we can rebuild the system as one design so it doesn't happen twice.

Do I need snow retention if I'm getting heat cable?

On slide-prone roofs — metal especially — often yes, because a slide can destroy the cable system. On roofs that hold their snow, often no. We'll tell you which one yours is at the assessment; we don't quote retention where it isn't earning its keep.

What about Girdwood?

Girdwood's design snow load is nearly three times Anchorage's — it's a different class of system: heavier continuous rails, denser rows, and manufacturer engineering on every job, sometimes with a structural check first. We quote it accordingly.

Keep the snow on the roof — and off everything below it.

Free on-site assessment. Engineered layout with every quote.

★★★★★ on Google · Engineered to your roof's snow load · Serving Anchorage, Eagle River, Girdwood & Wasilla
